Optical Transceiver Upgrade Checklist for Network Service Providers

Views : 1502
Update time : 2025-11-04 16:35:00


An optical transceiver upgrade should start with the service requirement and the installed network, not with a higher-speed module. Before procurement, confirm the host ports, software, fiber plant, reach, topology, loss budget, compatibility requirements and rollout plan.


This checklist helps network service providers, campus network teams and system integrators compare practical upgrade paths, including MMF versus SMF, conventional Ethernet optics and coherent pluggables. It also defines the evidence needed for a deployment-ready bill of materials, lab validation and controlled field rollout.


1. Define the performance and service objective

A faster transceiver does not correct congestion, packet loss, poor routing or an undersized switch fabric by itself. Record the current bottleneck and the result the project must achieve: higher port capacity, a longer route, additional wavelengths, lower power per bit, simpler operations or a staged migration.


  • Current and target data rate at both endpoints
  • Traffic baseline, utilization peaks and growth horizon
  • Service-level, protection and maintenance-window requirements
  • Target route, fiber ownership and available rack or port capacity
  • Budget, rollout quantity, spare policy and acceptance owner

2. Inventory the installed network before selecting optics

Build an A- and Z-end inventory for every route. Form factor alone is not enough to prove support. Record the exact chassis, line card or network adapter, port, current module, software release, connector, fiber type, route length and patching path.


Inventory areaRecordWhy it matters
Host platformChassis, card, port, software and licenseDetermines supported speed, media mode, coding and monitoring
Fiber plantMMF or SMF class, route length, connector, panels and splicesConstrains the optical application and available margin
TopologyDuplex, BiDi, parallel optics, breakout, CWDM or DWDMControls fiber count, wavelength pairing and patching
Current conditionOptical power, errors, alarms, connector condition and traffic baselineSeparates an upgrade requirement from an existing fault

3. Compare MMF and SMF for a campus backbone upgrade

For a 400 m campus backbone, do not choose fiber from cable cost per meter alone. Confirm the exact target rate and Ethernet application first, because supported reach depends on the transceiver standard, fiber class, connector loss and channel condition.


Existing multimode fiber (MMF) may be reusable for a supported application, which can reduce immediate construction work. Single-mode fiber (SMF) generally provides a broader path to longer-reach and future higher-rate applications. The correct comparison is installed lifecycle cost: cable, termination, panels, optics, labor, testing, spare strategy, future migration and the risk of replacing the fiber again.


  • Verify the installed fiber: identify the exact MMF or SMF class and test the real channel rather than relying on an old label.
  • Check the target application: match data rate, lane architecture and reach to the official transceiver specification.
  • Model total cost: include optics at both ends, patching, construction, testing and the expected next upgrade.
  • Protect migration flexibility: confirm spare fibers, connector strategy and whether parallel or wavelength-based scaling is planned.

Do not state that all MMF links or all SMF links support the same distance. The pass decision belongs to the exact optical application and measured channel.


4. Select the data rate, form factor and topology

Choose the end-to-end architecture before choosing a part number. Confirm whether the migration uses native-rate optics, breakout lanes, BiDi pairs, parallel fiber, CWDM or DWDM. A higher-density cage does not automatically support every lower rate, breakout mode or optical technology.


  1. Confirm the supported port mode and speed at both ends.
  2. Match form factor, connector and lane mapping.

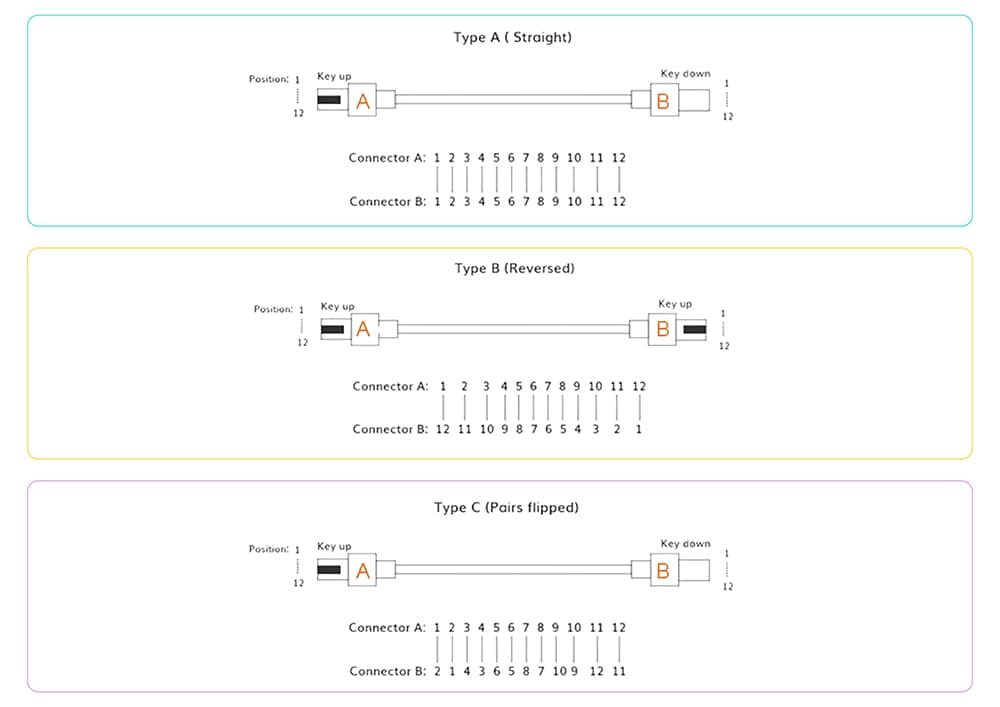

  3. For BiDi, verify complementary transmit and receive wavelengths as a pair.
  4. For breakout, confirm the host configuration and the exact AOC, DAC or fiber topology.
  5. For wavelength systems, confirm channel plan, mux or demux passband and power limits.

5. Decide whether coherent optics fits the route

Coherent pluggable optics can simplify some data-center interconnect, metro and regional designs, but adoption is not a simple form-factor replacement. A service provider must confirm the router or transport host, software and licensing, coherent application profile, optical line system and route engineering.


  • 400ZR: evaluate it where the route and hosts match the focused interoperable 400GbE application.
  • OpenZR+: evaluate supported profiles when broader metro or regional operating options are required.
  • Transponder-based design: retain it when required protection, regeneration, encryption, line control or management functions are not provided by the router-native design.

Do not select a coherent profile from map distance alone. Filters, ROADMs, amplifiers, connector loss, optical signal-to-noise ratio (OSNR), dispersion and operational margin can change the workable design.


6. Verify host compatibility, software and monitoring

Compatibility must be checked against the exact vendor platform, line card, port and software release. Confirm the approved coding profile, supported media mode, forward error correction (FEC), digital optical monitoring, power class, thermal allowance and any required license.


A module being recognized is only one check. It does not prove that the port configuration, remote endpoint, wavelength pair, fiber path or traffic behavior is correct. Record any unsupported-transceiver message and the complete device context before changing configuration.


7. Engineer the optical path and operating margin

Create a route record that includes fiber type and length, connector and splice loss, patch panels, mux or ROADM elements, transmitter and receiver limits, measured power and an engineering margin. For coherent routes, also use the platform vendor's planning method for OSNR, dispersion, filtering and amplification.

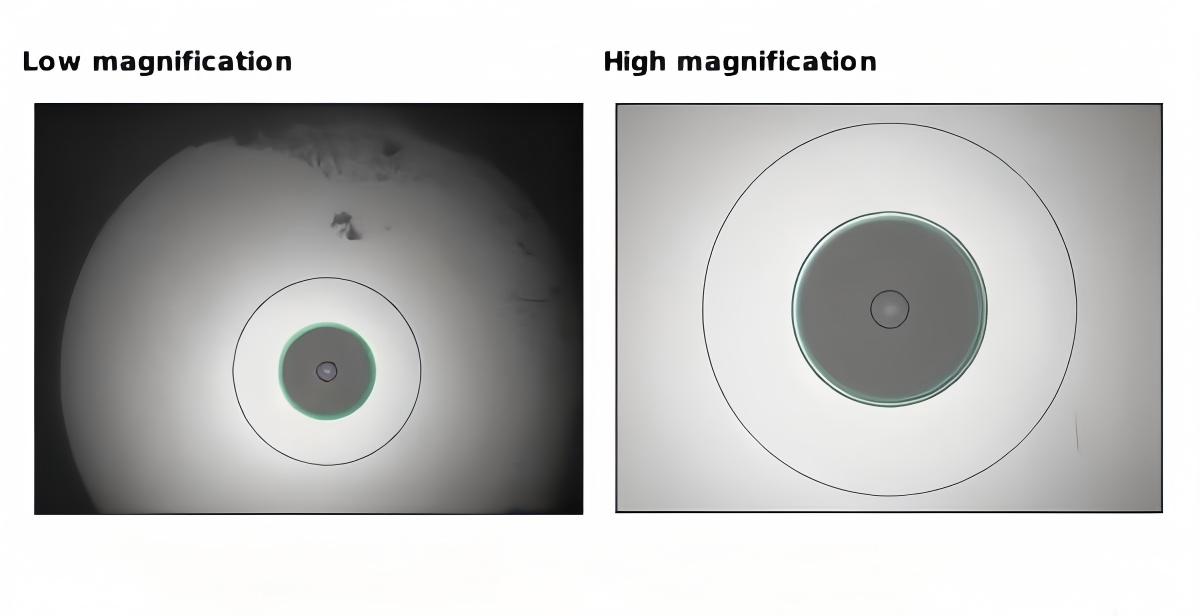

Clean and inspect connectors before treating low power as a transceiver failure. Preserve pre-change measurements so the team can compare the new link with the real baseline.


8. Build a deployment-ready optics BOM

The bill of materials should describe the complete link, not only two modules. Include both endpoints, approved coding, fiber and patch cords, adapters or cassettes, wavelength components, licenses, known-good spares, cleaning materials and the intended software baseline.


BOM fieldRequired detailValidation status
Endpoint opticsPart number, coding, rate, reach, connector and wavelengthApproved, test pending or rejected
Host contextPlatform, card, port, software, license and port modeDocument source and test evidence
Passive pathFiber, patch cords, panels, cassettes, muxes and adaptersMeasured, inspected or pending
OperationsSpares, labels, test access, rollback and acceptance ownerReady before maintenance window

9. Validate in the lab and run a controlled pilot

Reproduce the intended hosts, software, optics pair and port configuration in the lab where practical. Verify recognition, configuration, optical telemetry, error counters, sustained traffic, restart behavior and rollback. For a field pilot, choose one representative route and change one controlled variable at a time.


  1. Capture the pre-change configuration, alarms, power and traffic baseline.
  2. Inspect and clean the optical path.
  3. Install the validated pair and confirm the intended port mode.
  4. Run traffic, alarm, restart and protection tests against written acceptance limits.
  5. Preserve logs and roll back if the link is unstable or margin is inadequate.

10. Define rollout and acceptance criteria

A link coming up is not the end of the upgrade. Record the approved module revision, coding, software and configuration; baseline optical telemetry; error performance; spare matrix; rollback steps; alarm ownership; and post-change review interval. Scale only after the pilot evidence is accepted.


Frequently asked questions

Will a higher-speed optical transceiver automatically improve network performance?

No. It improves link capacity only when both hosts, the port configuration and the optical path support the new application. Congestion elsewhere, switch-fabric limits, packet loss or poor routing may require different corrective work.


Should a 400 m campus backbone use MMF or SMF?

Start with the target rate, exact optical application and installed channel. Reusing verified MMF may reduce immediate construction, while SMF generally provides more flexibility for longer-reach and future higher-rate applications. Compare total installed lifecycle cost, not cable price alone.


Can existing multimode fiber be reused during an upgrade?

It may be reusable when its fiber class, measured channel condition, connector path and total length meet the exact transceiver application's requirements. Test the installed channel and retain margin for patching and future changes.


Does every QSFP-DD port support coherent optics?

No. Physical fit does not prove coherent support. Confirm the exact chassis, line card, port, software, power and thermal limits, management interface and licensing for the selected module.


Does standards compliance guarantee interoperability?

No. Standards provide an important interface baseline, but deployment still requires validation of the exact module pair, host software, operating profile, FEC, wavelength plan and optical path.


What information is needed to prepare an optics BOM?

Provide the A- and Z-end platforms and ports, current and target rates, fiber type and length, connector and topology, quantities, software releases, required rollout date and any protection, wavelength or compatibility constraints.


Technical references

Prepare the route inputs before requesting an optics BOM

Share the A- and Z-end platform models, port types, software releases, target rate, fiber type and route length, connector and topology, quantities and rollout schedule.

Axonode can help organize a project-specific optics BOM and coordinate product selection, coding, sourcing and validation requirements with vetted OEM manufacturing and testing partners. Review the optical transceiver range, see the enterprise and campus solution or contact Axonode with the route details
